Introduction
Here's a number that should change how you think about your next fabrication project. Engineering decisions made at the design stage can commit up to 80% of a product's total cost, before a single piece of material gets cut.
That's according to research published in the ASME Journal of Manufacturing Science and Engineering.
That's a planning problem, not a production one.
Budget overruns, schedule delays, wasted material, and rework rarely trace back to raw material prices or labor rates alone. They trace back to decisions made weeks or months before anyone picked up a torch.
Fabrication costs span a huge range — a small custom bracket might cost a fraction of a large structural steel package. But that range is driven far more by planning quality than by the price of steel on any given day.
Fabrication isn't inherently expensive. It becomes expensive through sequencing gaps, oversight failures, and decisions made without shop-floor input. This article breaks down where those costs actually come from and what you can do about it.
Key Takeaways
- Most avoidable fabrication cost gets locked in during design, not production
- Poor coordination between design, procurement, and the shop floor hides costs until it's too late
- Cost-reduction strategies fall into three categories: decisions, management, and project context
- A full-service fabrication partner engaged early eliminates several costly handoffs
How Costs Around Fabrication Planning Typically Build Up
Fabrication cost doesn't show up as one line item. It builds in layers.
It starts with design assumptions: a tolerance spec here, a material grade there. Those choices compound through procurement lead times, where material availability and order quantity start affecting your schedule. The full cost only becomes visible once parts hit the shop floor or the job site.
Two patterns drive this build-up:
- Gradual and compounding: small inefficiencies stack across design, ordering, and production until they add up to real money
- Episodic: a late design change, an unexpected change order, or a site condition discovered mid-project creates a sudden cost spike
Here's the part that catches most project owners off guard: some costs are visible upfront in the initial quote. Material and base labor, for example, are usually right there in black and white.
Others stay hidden until something forces them into view:
- Scrap rates from poor material layout
- Rework triggered by design or fabrication errors
- Idle equipment time from scheduling gaps
- Expedited shipping fees when a project falls behind
These hidden costs don't announce themselves. They surface only when scale, scheduling stress, or an execution failure exposes them, usually at the worst possible time.

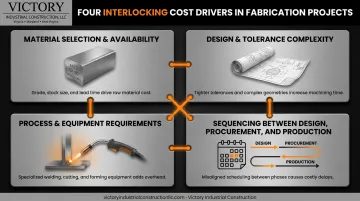

Key Cost Drivers for Fabrication Planning
The cost profile of any fabrication project comes down to four interlocking factors, and none of them are really about the fabrication work itself.

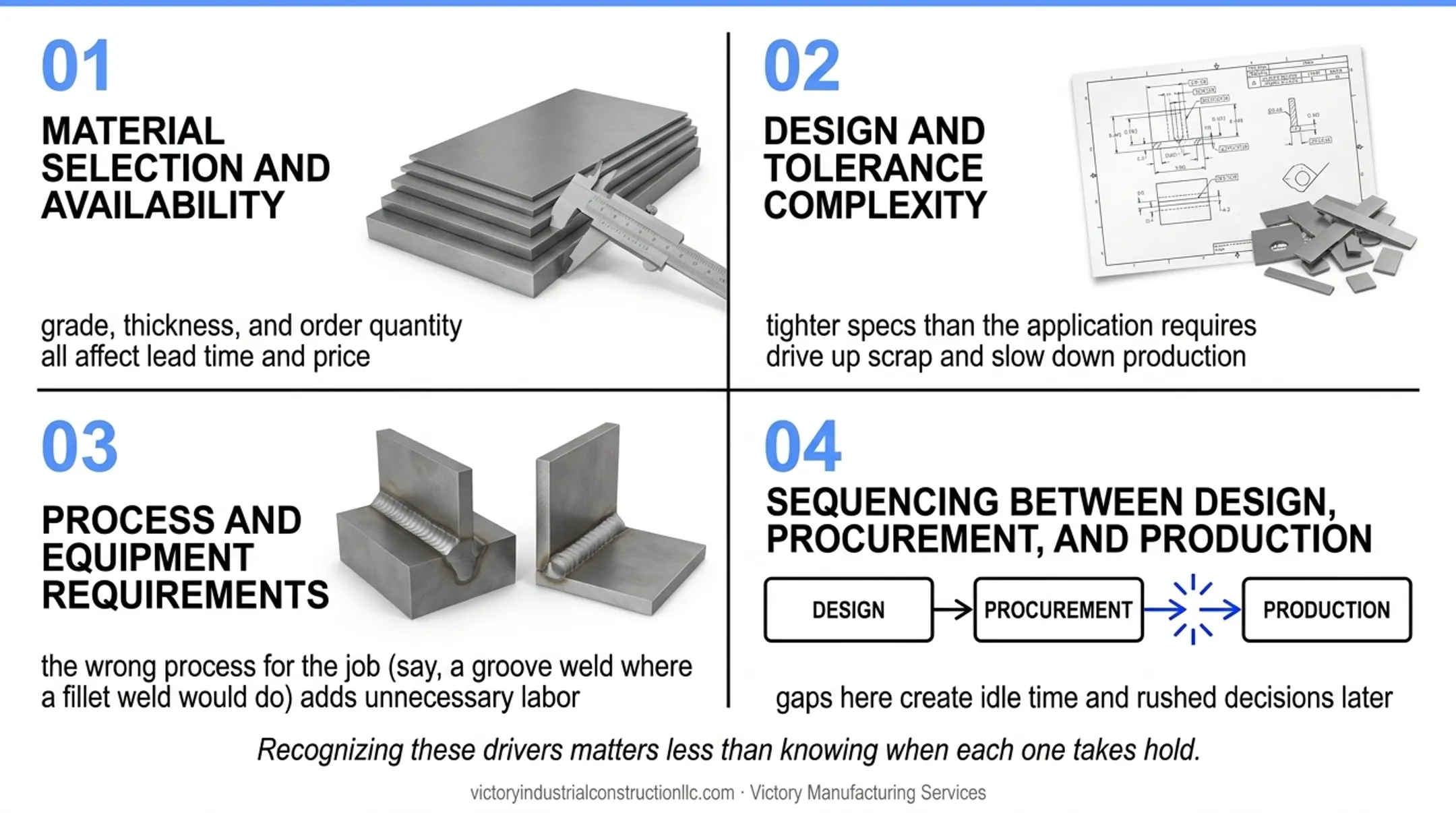

What Actually Shapes the Cost
- Material selection and availability — grade, thickness, and order quantity all affect lead time and price
- Design and tolerance complexity — tighter specs than the application requires drive up scrap and slow down production
- Process and equipment requirements — the wrong process for the job (say, a groove weld where a fillet weld would do) adds unnecessary labor
- Sequencing between design, procurement, and production — gaps here create idle time and rushed decisions later

Recognizing these drivers matters less than knowing when each one takes hold.
Where Each Driver Originates
Cost exposure builds in stages, and each stage carries its own risk:
- Early-stage: specifications, drawings, and vendor selection lock in cost before fabrication even begins
- Mid-project: scope creep, revised drawings, and delayed approvals reshape cost after work is underway
- Production-stage: site access issues, subcontractor coordination problems, and equipment availability constraints surface during the build itself
The AISC/NSBA guide to accelerated steel fabrication puts it plainly: unnecessary shop assembly requirements alone can delay a project by weeks or months. That's cost, even if it never appears as a separate line item.
Which driver dominates depends on your project type. A one-off custom bracket, a repeat production run, and an on-site structural install each carry a different risk profile, so a one-size-fits-all cost strategy rarely works.
Cost-Reduction Strategies for Fabrication Planning
Effective cost reduction isn't a single tactic. It depends on where in the process you're intervening : the decisions being made, how the project is managed once it's underway, or the broader context surrounding the work.
Strategies That Reduce Costs by Changing Decisions
These are the choices made before fabrication begins, and they carry the most leverage.
- Bring the fabricator in during design, not just at quoting. When Victory Industrial Construction gets involved early, material and process choices reflect what the shop can actually do efficiently, not just what looks good on a drawing.
- Specify materials and tolerances based on functional need. Overly tight tolerances reduce process yield and increase scrap, without adding real performance value.
- Standardize hardware and part designs where possible. Custom fasteners and one-off components add cost that repeat components don't.
- Match the process to actual project volume. Over-specifying a production-grade process for a single unit wastes money in the other direction.
Strategies That Reduce Costs by Changing How Planning Is Managed
Once a project is active, the goal shifts to control, visibility, and consistency.
- Run procurement and shop scheduling in parallel, not strictly one after another. Waiting for material to arrive before scheduling shop time creates dead time that doesn't need to exist.
- Use nesting software to raise material utilization on raw stock. Documented cases show gains from 64.83% to 95.96% with a single layout adjustment, per The Fabricator — Victory applies the same software to cut waste per sheet.
- Build in checkpoints between engineering and the shop floor before drawings are finalized. Catching a design issue before it's locked in is dramatically cheaper than catching it after.
- Track scrap rates, rework frequency, and schedule slippage across projects. One-off mistakes are normal. Repeating patterns are a planning gap.

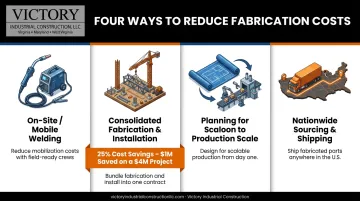

Strategies That Reduce Costs by Changing the Context
Sometimes the real cost driver isn't the fabrication work at all. It's the project setup around it.

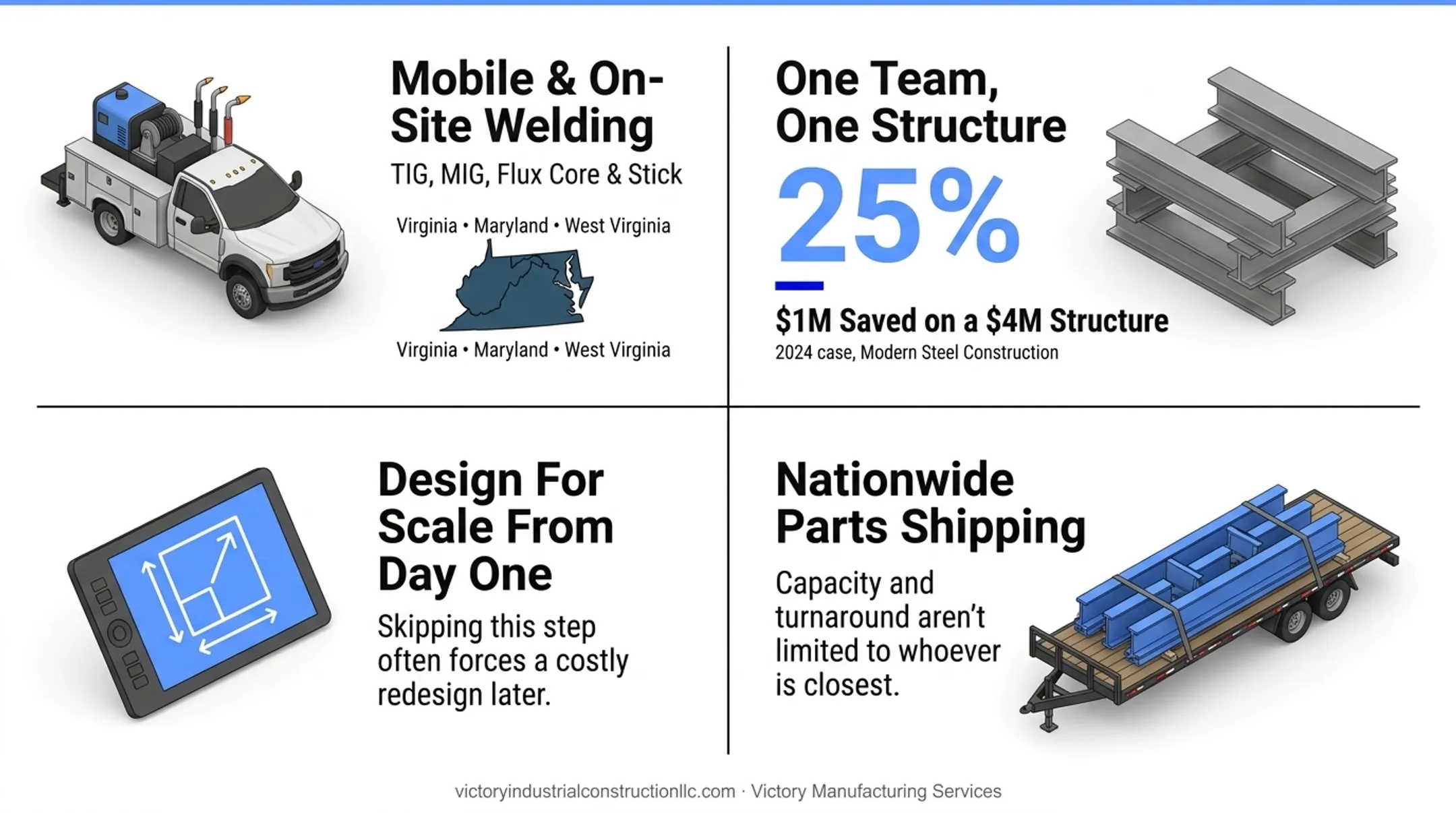

- Use on-site or mobile welding capability instead of shuttling parts and crews between locations. Victory's mobile welding covers TIG, MIG, flux core, and stick processes across Virginia, Maryland, and West Virginia, eliminating the transport and rigging costs of moving heavy components to a shop.
- Consolidate fabrication, welding, structural steel, and installation with one provider. A 2024 case in Modern Steel Construction saved 25% on a steel package, including $1 million on a $4 million structure — one case, not a guarantee, but a sign of what's possible when a single team owns design through erection.
- Plan for scale from the start. A prototype that isn't designed with production in mind often requires a costly redesign later.
- Broaden your sourcing options. Victory ships fabricated parts nationwide, which means capacity and turnaround aren't limited to whoever happens to be closest.

Conclusion
Reducing fabrication cost starts with identifying where the cost actually originates, usually earlier in the process than most teams realize. Cutting spend after a project runs over budget only addresses symptoms, not the source.
Effective cost reduction is strategic and ongoing, not a one-time fix. It requires looking at decisions, management practices, and project context together, not in isolation.
Partnering with a full-service fabrication contractor like Victory Industrial Construction from the planning stage, rather than bringing them in once drawings are already locked, prevents many of these costs from building up in the first place.
Frequently Asked Questions
What does fabrication cost mean?
Fabrication cost covers the material, labor, equipment, and processing expenses required to cut, form, weld, and finish raw material into a finished part or structure. It reflects the full production effort, not just the price of raw stock.
How do you reduce cost in a manufacturing company?
Costs come down by combining smarter upfront design and material decisions with tighter process management and reduced waste across production and logistics. These strategies work best applied together, not in isolation.
How does Lean 4.0 reduce costs by 30% in manufacturing?
Lean 4.0 pairs traditional lean waste-reduction principles with digital tools to spot inefficiencies in real time. A McKinsey Industry 4.0 report cited a 30%+ unit-cost reduction as a goal for one specific factory program; actual results vary by facility and implementation depth.
What is fabrication planning?
Fabrication planning is the process of coordinating design, material sourcing, scheduling, and production sequencing before and during a fabrication project. It covers everything from shop drawings to delivery and site logistics.
When should a fabricator be involved in project planning?
As early as the concept or design stage, when changes are still inexpensive to make. Waiting until quoting means many cost-driving decisions are already locked in.
Does better fabrication planning also affect lead times?
Yes. The same improvements that reduce cost (standardized materials, better sequencing, fewer late changes) typically shorten lead times as well. Cost and schedule problems usually share the same root causes.
