"Prototype to production" gets thrown around constantly in engineering and procurement meetings. Fewer people can actually walk through the operational steps, decision points, and failure modes hiding behind the phrase. This article breaks down how the process really works, what shapes a smooth scale-up, and where OEMs commonly trip up.
Key Takeaways
- Skipping stages between validation, manufacturability review, and bridge production creates the costliest failures.
- Material choice (carbon steel, stainless, aluminum) changes cutting, forming, and welding at every stage.
- Choosing one fabricator to span prototype through production removes costly handoff risk.
- One-off or low-volume orders can skip the staged process and go straight to production.
What Is Prototype-to-Production Manufacturing?
It's the structured progression of a part or assembly from a proven, working prototype through pilot or bridge quantities to full-scale, repeatable manufacturing output. The end goal is simple to state, harder to achieve: a manufacturing-ready design and process that consistently produces conforming parts at the volume, cost, and speed the OEM's program actually requires.
This differs from two things people often confuse it with:
- Pure prototyping validates form, fit, and function only — it doesn't confirm the part can be made the same way 500 times in a row.
- Mass production assumes the design and process are already fixed. Prototype-to-production is the bridge that gets you there.
- Bridge production covers the limited-run quantities in between, proving the process before you commit to full tooling.
A part that works perfectly as a one-off prototype can still fail spectacularly once you try to reproduce it at volume. Closing that gap means validating the process itself, not just the part, across every single run.
Why OEMs Rely on a Structured Prototype-to-Production Process
OEMs design products but outsource fabrication. That split creates a specific risk: if the manufacturing partner doesn't follow a staged process, the OEM inherits whatever manufacturing problems show up later. Often that happens after tooling money is spent and delivery dates are already committed.

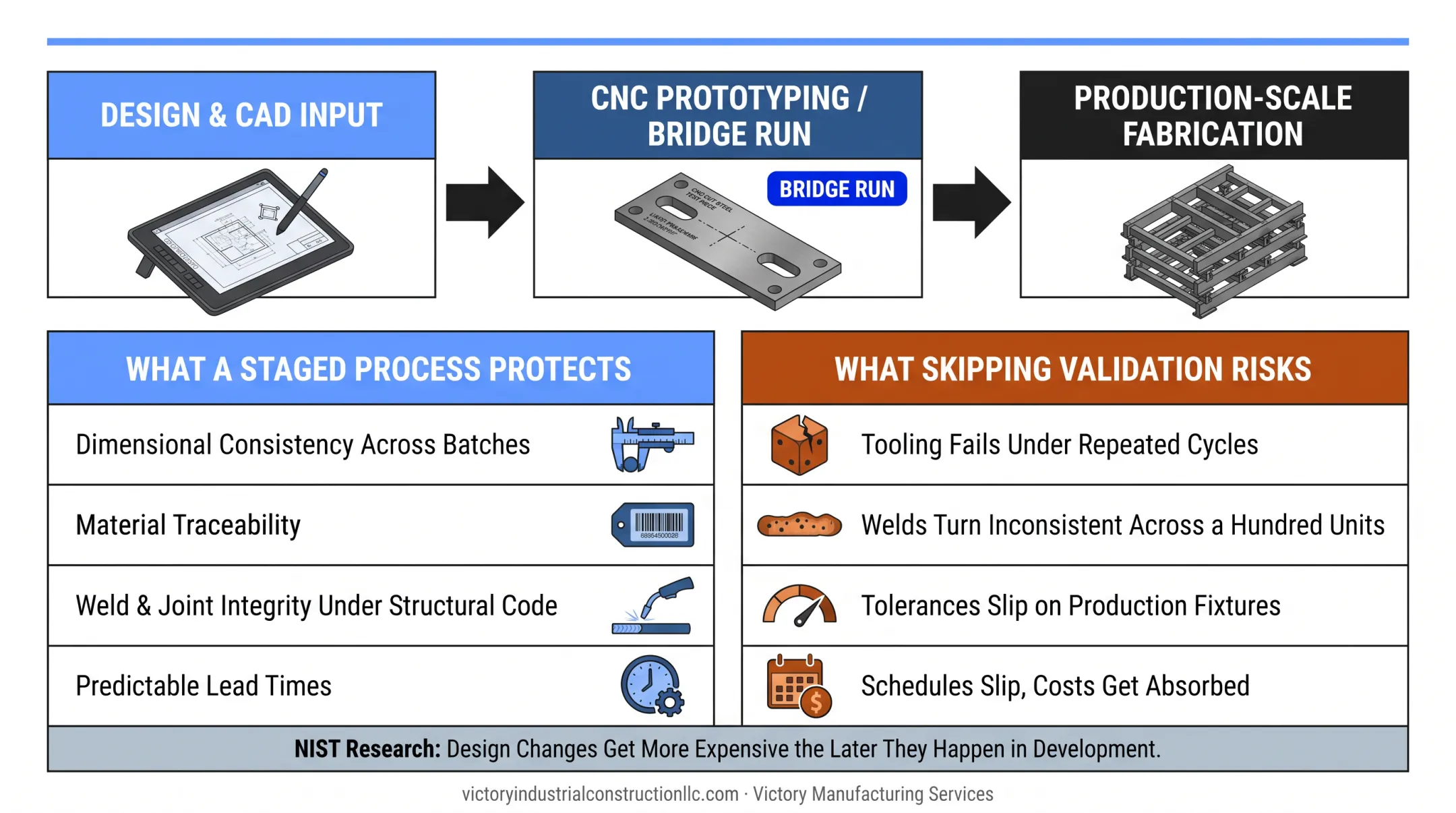

A staged process protects the things OEM programs actually depend on:
- Dimensional consistency across batches, not just within one prototype run
- Material traceability, particularly when contracts or industry codes require it
- Weld and joint integrity that holds up under the applicable structural welding code
- Predictable lead times that downstream assembly lines can actually plan around
Skipping the intermediate validation stage is where things go wrong:
- Tooling fails under repeated cycles that a single prototype never tested
- Welds that looked fine on one unit turn inconsistent across a hundred
- Tolerances achievable by hand on a prototype bench slip once a production fixture is introduced
- Schedules slip, and OEMs absorb costs that a bridge run would have caught for a fraction of the price
NIST research on manufacturing cost estimation confirms that design changes get more expensive the later they happen in development. Failing to hit a target cost is a documented cause of changes made during the production stage itself, not before it.
This staged approach isn't a formal regulatory requirement in most industries. It's a best practice adopted by experienced manufacturers and OEM engineering teams because it works, though certain sectors layer on compliance checkpoints of their own.
This is also where partner selection matters most. A full-service fabricator handles design input, CNC-driven prototyping, and production-scale fabrication under one roof. Victory Industrial Construction works this way, removing the handoff risk that shows up when prototype work sits with one vendor and production work sits with another.

How the Process Works: From Prototype to Full-Scale Production
At a high level, the flow looks like this: a validated prototype comes in, goes through a manufacturability review and process planning, moves into controlled small-batch production, then scales up to full serial output.
What starts the process:
- CAD files
- A bill of materials
- Prototype test results
- Target volumes and tolerances from the OEM
What happens during the core transformation:
- Material selection (carbon steel, stainless steel, or aluminum)
- CNC cutting and forming setup
- Welding process selection: TIG, MIG, flux core, or stick
- Tooling and fixture development
How the process stays controlled:
- Nesting software for material efficiency and waste reduction
- Quality checkpoints between batches
- Documented process parameters that don't change from run to run
The output is a repeatable, documented manufacturing process capable of consistent results at the OEM's required volume, not just a single good part.
Step 1: Design for Manufacturability (DFM) and Process Planning
This is where the prototype design gets reviewed for simplification, material compatibility, and manufacturability. It's also the stage that determines the bulk of eventual per-unit cost, since decisions made here (bend radii, tolerance callouts, material grade) carry through every unit produced afterward.
A common example from metal fabrication illustrates this well: a 6061-T6 aluminum cover was crack-sensitive and difficult to bump-form. Switching to 5052 aluminum and adjusting the geometry made the part far easier and cheaper to form, without changing how it functioned. Tolerances get scrutinized here too: a tolerance that's easy to hit by hand often needs revising once press-brake production takes over.
Step 2: Low-Volume or Bridge Production
A small batch, anywhere from tens to a few hundred units, gets produced to validate the manufacturing process itself, not just the design. This catches tooling and fit issues before they multiply across a full production run, and it gives the OEM real, production-representative parts to run downstream testing against.
ASME's research on low-volume manufacturing points out that small-batch processes let prototype and production units share similar components and materials, which enables earlier performance testing and catches problems before they surface as first-article surprises in full production.
Step 3: Scale-Up to Serial Production

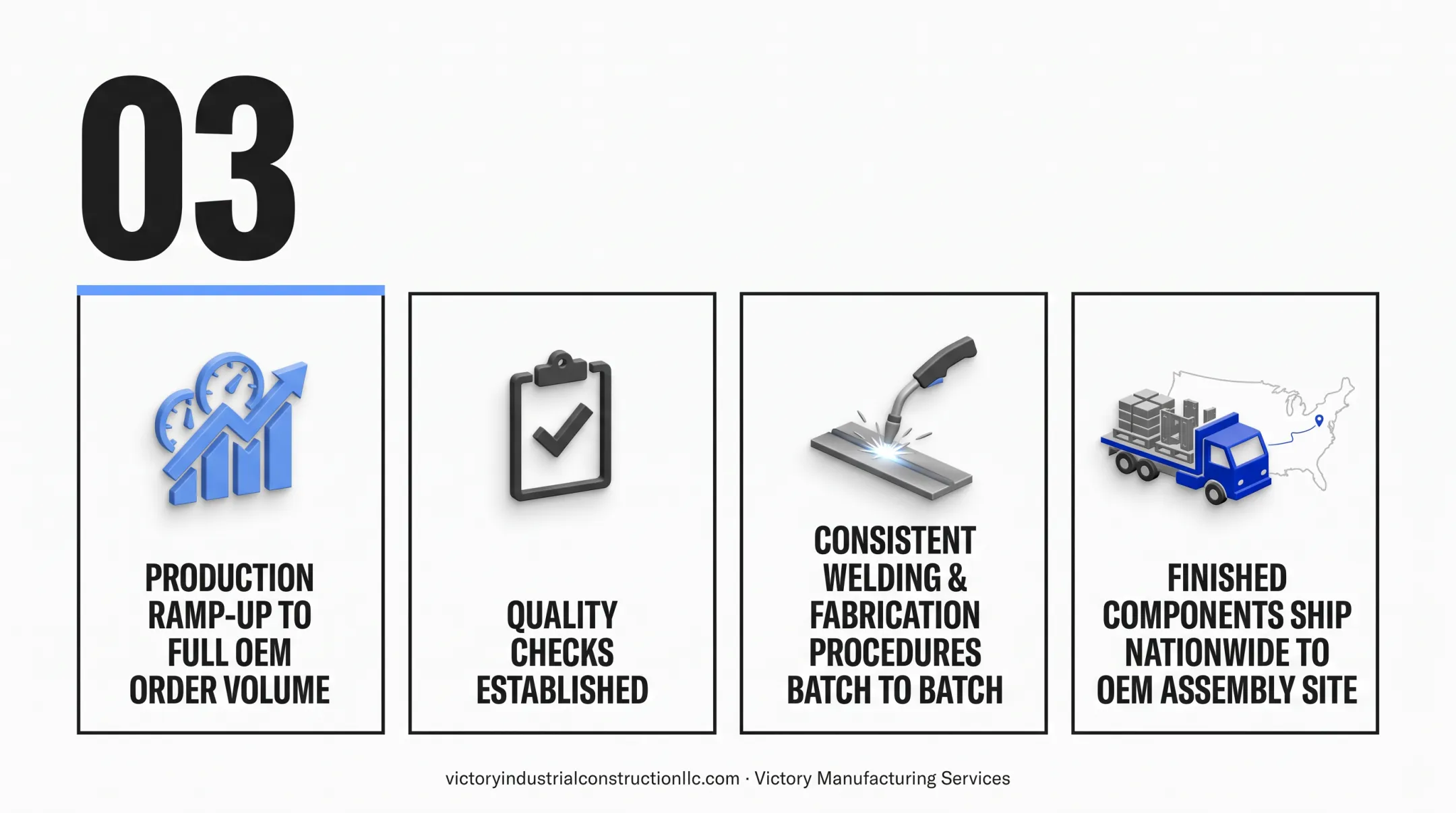

Once the process is validated, production ramps to the OEM's full order volume. Quality checks are established, welding and fabrication procedures stay consistent batch to batch, and finished components ship, often nationwide, to the OEM's assembly site.

Key Factors That Affect the Process for OEMs
Several variables shape how smoothly this transition goes:
- Material inputs: Switching between carbon steel, stainless steel, and aluminum changes cutting, forming, and welding needs. AWS maintains separate welding codes for each material, so a process qualified for one material doesn't automatically transfer to another.
- Operating conditions: Batch size, part complexity, and tolerance requirements all change how effective a given process is at each stage.
- Equipment dependencies: In-house CNC plasma cutting, precision brakes, tube bending, and multi-process welding (Victory Industrial Construction's setup) cut the outsourcing delays that come from splitting prototype and production work across vendors.
- Scale and throughput: OEM order volume determines whether bridge production makes sense or whether a direct move to serial production is more efficient.
- Regulatory or quality constraints: Material certifications, weld inspection records, and documented traceability requirements vary by industry and by contract. Confirm these requirements early, not after the process begins.
Common Pitfalls, Misconceptions, and When This Process May Not Be the Right Fit
A few assumptions cause most of the trouble OEMs run into during scale-up.

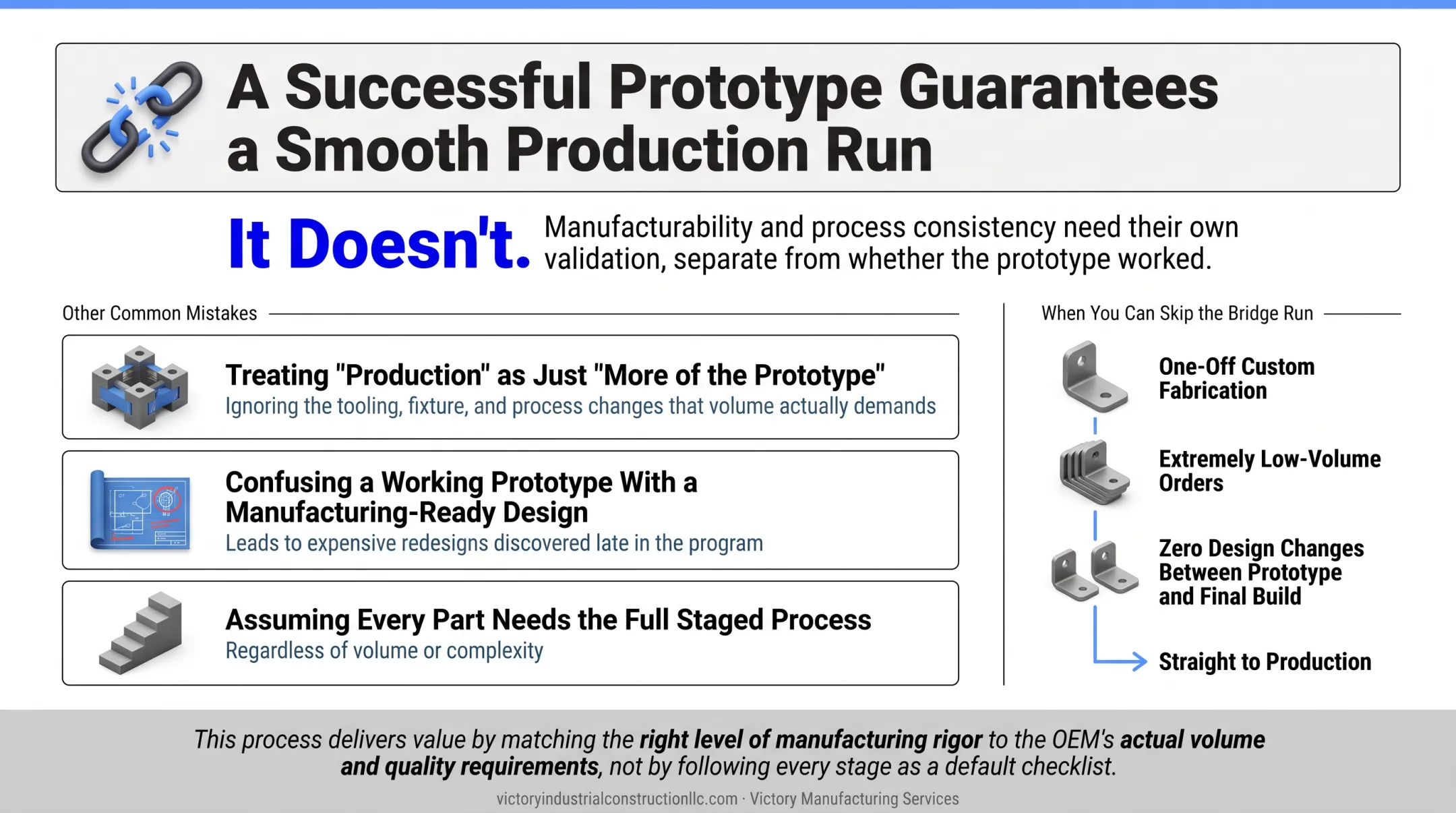

The biggest misconception: a successful prototype guarantees a smooth production run. It doesn't. Manufacturability and process consistency need their own validation, separate from whether the prototype worked.
Other common mistakes:
- Treating "production" as just "more of the prototype," while ignoring the tooling, fixture, and process changes that volume actually demands
- Confusing a working prototype with a manufacturing-ready design, which leads to expensive redesigns discovered late in the program
- Assuming every part needs the full staged process, regardless of volume or complexity
The full process isn't always necessary. One-off custom fabrication, extremely low-volume orders, or parts that require zero design changes between prototype and final build can often skip straight to production without a bridge run.
This process delivers value by matching the right level of manufacturing rigor to the OEM's actual volume and quality requirements, not by following every stage as a default checklist.

Frequently Asked Questions
How do you go from prototype to production?
Validate the prototype's design for manufacturability, run a small bridge or pilot batch to confirm the process holds up, then scale to full production once quality and repeatability are confirmed.
What is a prototype in production?
In a production context, a prototype is a pre-production build used to confirm that the design and the intended manufacturing process will perform and hold tolerance at scale. It's proof the process works, not just the concept.
What are the stages of prototyping typically referenced in industry?
Teams commonly reference concept or proof-of-concept, design refinement, pre-production or engineering validation, pilot/bridge production, and full production. These labels serve as a common framework, not a single standardized industry taxonomy.
What are the common classifications of prototypes?
Four types come up most often: proof-of-concept, form (looks-like) prototypes, functional (works-like) prototypes, and pre-production (production-representative) prototypes.
How long does it typically take to move from prototype to production manufacturing?
Timelines vary by part complexity, tooling needs, and volume. A straightforward metal fabrication project can often move from validated prototype to production within weeks, while complex assemblies take considerably longer.
What should OEMs look for in a prototype-to-production manufacturing partner?
Look for in-house CNC cutting, multi-process welding, and CAD/nesting capability so prototype and production work stay under one roof. That combination reduces handoff delays and the quality inconsistencies that come with switching vendors mid-program.
